W2.1_YN_Cost Estimate of IT System
W2.1_YN_Cost Estimate of IT System
Opportunity Statement
OPWP is currently in the process of establishing the Spot
Market, which is a day-ahead market in which generators submit daily bids to
sell electricity produced at their plants. In order to operate the market, an
IT system needs to be procured. In this blog, different cost estimation
techniques are compared, and used to present a cost estimate of the IT system.
Feasible Alternatives
The cost estimating techniques to be compared are the
following:
-
Expert Judgment.
-
Analogous Estimating
-
Parametric Estimating.
-
Bottom-Up Estimating.
-
Three-Point Estimating.
-
Algorithmic Methods.
Outcomes of Feasible Alternatives
The method through which
cost estimating is performed in each of the techniques is as follows:
-
Expert Judgment: experts in the relevant area utilize their experience
and understanding of the proposed project, in addition to historical data
collected throughout their career to provide a cost estimate.
-
Analogous Estimating: this method utilizes information, such as scope,
duration, complexity, and cost, which are available on previous projects that
are similar in nature to the proposed project. The cost estimate of the
previous projects is scaled to fit the characteristics of the project in hand.
-
Parametric Estimating: a statistical relationship is developed between the
historical data and a relevant unit of measurement such as the cost per
source line of code needed in the case of IT systems. This relationship from
historical data is then used to estimate the cost of the upcoming project.
-
Bottom-Up Estimating: in this technique, the detailed cost of the
activities needed to complete the project is aggregated to estimate the cost of
the project.
-
Three-Point Estimating: This technique takes into account the
uncertainty of a single value of estimated cost by looking at a range of values
between three points: the most likely, the optimistic, and the pessimistic
values. Algorithmic Methods.
-
Algorithmic Methods: These methods utilize mathematical equations that in
addition to historical data, they take inputs such as size, complexity, and the
development environment of the software into account to calculate the estimated
time and cost of building the software. These methods include COCOMO models and
Function Point method which take the number of source lines of code and the
number of functions delivered to the user as an input, respectively.
Acceptable Criteria
The criteria based on which we shall choose the cost estimating
technique are availability of data, accuracy, and resources needed to perform
the technique in terms of time and money.
Analysis and Comparison of
the Alternatives
Considering that no historical data is available, this
makes it difficult to use techniques that rely on such input to provide
acceptable estimates. This includes the use of Analogous, Parametric, and Algorithmic
methods.
Additionally, Bottom-up Estimating is time consuming and
shall be reserved for the later stages of the project once the tendering of the
IT system is initiated, and more personnel are available to conduct such
analysis.
On the other hand, Expert Judgement is easier to perform.
Moreover, experts utilize some of the other methods in making their estimate such
as Analogous Estimating since they rely on their experience of similar projects
to make their estimate, making them relatively reliable and accurate. Combined
with Expert Judgement, the Three-Point Estimating can be performed to account
for the uncertainty in the scope at this stage of the project.
Preferred Alternative
In order to assist with the procurement of the IT system a team of advisors was hired. During the bidding stage of hiring the advisors, the bidders were asked to estimate the cost of the IT system based on the data available. The bidders’ estimates ranged from USD 4 million to 7 million with USD 6 million being the most likely value*. Considering the data available, the Expert Judgement and Three-Point Estimating techniques are used as discussed in the analysis above.
Using the three values above, the PERT

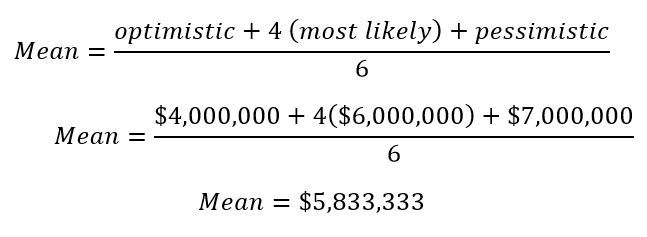

formula can be used to take uncertainty into account. The formula yields a mean
value for the cost estimate and results in a Normal Distribution, as follows:In order to assist with the procurement of the IT system a team of advisors was hired. During the bidding stage of hiring the advisors, the bidders were asked to estimate the cost of the IT system based on the data available. The bidders’ estimates ranged from USD 4 million to 7 million with USD 6 million being the most likely value*. Considering the data available, the Expert Judgement and Three-Point Estimating techniques are used as discussed in the analysis above.
Additionally, the standard deviation is calculated as
follows:
Confidence levels P80 and P90 values can be calculated
using the z-score as shown in the following equation, the results of which is summarized
in table 1 below.
Table 1: Different confidence levels
values
Confidence Level
|
z-score
|
Estimated Cost
|
50%
|
0
|
$5,833,333
|
80%
|
0.85
|
$6,258,333
|
90%
|
1.29
|
$6,478,333
|
Depending on the confidence level desired, the management
can use the estimated cost accordingly.
Tracking and Reporting
The estimated costs above are based on the level of
information available at this stage of the project. As we progress with the
procurement of the IT system vendor, more detailed and accurate cost estimation
techniques can be utilized such as Bottom-up Estimating. The updated estimates shall
be compared to the current values, and the discrepancy shall be analyzed for
its root causes.
* The numbers are multiplied
by a factor for confidentiality reasons.
References
(1) Project management institute.
(2013). A
guide to the project management body of knowledge: PMBOK guide.
Newtown Square, Pennsylvania: Project management Institute.
(2) What is PERT and
3-Point Estimate? (n.d.). Retrieved from
https://www.pmbypm.com/3-point-estimate-is-different-from-pert/
(3) Tutorialspoint.com.
(2017, August 15). Estimation Techniques Three Point. Retrieved from
https://www.tutorialspoint.com/estimation_techniques/estimation_techniques_three_point.htm
(4) Standard Normal
Probabilities. (n.d.).
Retrieved from http://www.stat.ufl.edu/~athienit/Tables/Ztable.pdf
(5) The Comparison of the Software Cost
Estimating Methods. (n.d.). Retrieved from
http://www.computing.dcu.ie/~renaat/ca421/LWu1.html
Good posting Yaarub!!! However, whenever you create an analysis you have to be clear in stating that the TARGET always remains the P50 value and that the DIFFERENCE between the P50 and P85 or P90 is the CONTINGENCY. You also need to know that CONTINGENCY has been ALLOCATED to a specific Work Package or Activity and is owned and managed by the PROJECT MANAGER. Contingency is used to cover KNOWN UNKNOWNS, while MANAGEMENT RESERVE is NOT allocated and is both owned and controlled by Senior Management and is used to cover UNKNOWN UNKNOWNS.
ReplyDeleteAnother good blog topic that goes with your topic would be to clarify the difference between ACCURACY, RELIABILITY and PRECISION in either cost or duration estimating. Go HERE http://www.planningplanet.com/guild/gpccar/introduction-to-managing-cost-estimating-budgeting and scroll on down to Figure 11. These are the 3 KPI's you need to adopt whenever you are benchmarking either cost or duration estimates.
BR,
